Project Summary
- Upgrades for Fire Safety
- Upgrades of Mechanical Systems
- Technology Upgrades
- Upgrades for Safety and Security
- Site Retaining Wall Repairs
Project Timeline
Last Update: January 21, 2018
Project Notes
February 21, 2019 – Avery Elementary Life Safety
HVAC Upgrades
Work has been completed on the HVAC equipment upgrades at Avery Elementary School. The project involved the replacement of the existing HVAC equipment in the building and improvements in life safety items. Life safety and security considerations that were taken care of included the installation of a fire sprinkler system throughout the building, inclusion of a new security entrance vestibule and additional cameras around the perimeter of the building. The project also included the replacement of some existing railroad tie walls located at a couple of areas on the site that are starting to tip and lean and to replace them with new concrete block segmental retaining walls.
July 8, 2018 – Avery Elementary
Life Safety/HVAC Upgrades

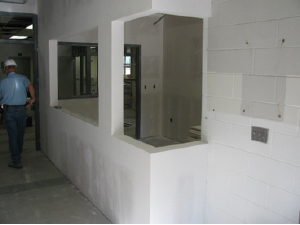

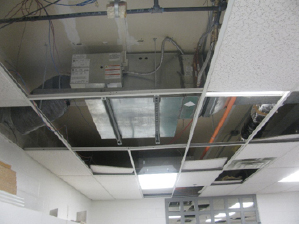

Work is progressing well at Avery Elementary. The current project involves the replacement of the existing HVAC equipment in the building and improvements in life safety items. Life safety and security considerations that will be taken care of include the installation of a fire sprinkler system throughout the building, inclusion of a new security entrance vestibule and additional cameras around the perimeter of the building. The project also includes the replacement of some existing railroad tie walls located at a couple of areas on the site that are starting to tip and lean and to replace them with new concrete block segmental retaining walls. Work is anticipated on being completed the first week of August and prior to the start of the upcoming school year.
May 8, 2018 – Avery Elementary
Life Safety/HVAC Upgrades
The Bellevue School Board has approved the bid from Lueder Construction to proceed with the planned life safety, building maintenance, building security and HVAC upgrades in the building. Life safety and security considerations that will be taken care of include the installation of a fire sprinkler system throughout the building, inclusion of a new security entrance vestibule, and construction of new stairwell enclosures to comply with current fire codes. HVAC upgrades will include the replacement of the existing chiller/condensing units, replacement of the individual unit VAV boxes that serve the individual classroom, and replacement of the existing boilers and main air handler unit. The project also includes the replacement of some existing railroad tie walls located at a couple of areas on the site that are starting to tip and lean and to replace them with new concrete block segmental retaining walls. Work will begin on the project at the end of May and should be substantially complete in time for the start of school in August 2018.
January 2, 2018 – Avery Elementary
The Bellevue School Board has approved the process of going out to bid for planned work at Avery Elementary to complete life safety, building security and HVAC upgrades in the building. Life safety and security considerations that will be taken care of include the installation of a fire sprinkler system throughout the building, inclusion of a new security entrance vestibule, and construction of new stairwell enclosures to comply with current fire codes. HVAC upgrades will include the replacement of the existing chiller/condensing units and replacement of the individual unit VAV boxes that serve the individual classrooms. Pricing will also be received on replacement of existing boilers and main air handler unit to determine if these items will be included (budget dependent) since these items will also be nearing the end of their window of useful use expectancy. Work identified within the scope of the bond work also includes the repair/replacement of some existing railroad tie walls located at a couple of areas on the site. It is anticipated that work on the project will begin in mid-May and should be substantially complete in time for the start of school in August 2018.
